South Dakota Department of Transportation US 385 Construction Project Skip to main content

The South Dakota Department of Transportation (SDDOT) is reconstructing a portion of Highway 385 between the Pennington-Lawrence county line and the south end of Sheridan Lake. Once completed, this section of Highway 385 will feature safety improvements, including wider shoulders on each side of the road where possible, improved road curves to meet current design standards, additional turning lanes to improve traffic flow, and new surfacing. Learn more about this project by watching this presentation.

Phase Map
Inset Map on South Dakota

Click on image to enlarge.

Approximately 15 miles of Highway 385, from Calumet Road (near Sheridan Lake) to the Pennington-Lawrence county line in South Dakota, is planned to be reconstructed from 2024 through 2026. Construction of Highway 385 is split into sections that will be completed over three years. The northern segment, which runs from Pactola Dam to the Pennington-Lawrence county line, is expected to be under construction in 2024. The southern section, which runs from the southern point of Sheridan Lake (Calumet Road) to Pactola Dam, is expected to be under construction in 2025 and 2026.

Construction Timeline

Construction began in the spring of 2024 and is anticipated to be completed in the fall of 2026. For further updates, please visit the Construction Updates page.

  • 2023

    Community & Stakeholder Outreach
  • 2024

    Phase 1 Construction
    (Pennington-Lawrence County Line to Pactola Dam)
  • 2025

    Phase 1 Surfacing & Phase 2 Construction
    (Pactola Dam to Calumet Road near Sheridan Lake)
  • 2026

    Phase 2 Construction
    (Pactola Dam to Calumet Road near Sheridan Lake)
  • 2027

    Phase 2 Surfacing

What to Expect

Phase 1 Construction Details

Click on image to enlarge.

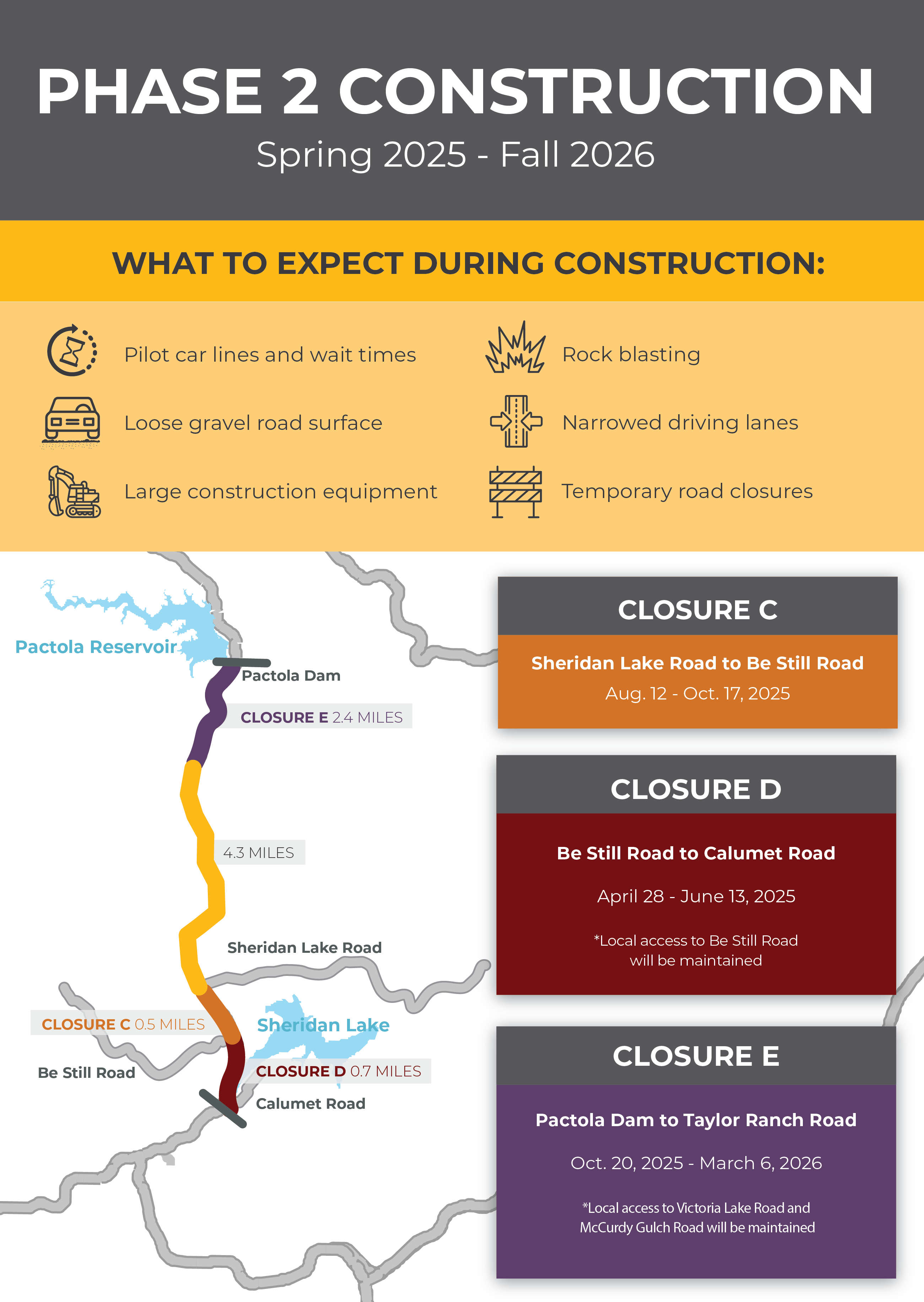

Phase 2 Construction Details

Click on image to enlarge.

The detour for these road closures will be S.D. Highway 44 and U.S. Highway 16, as show in yellow below.

Phase 1 Construction Details

Click on image to enlarge.

Construction Updates

Nov. 15, 2024

Expect flaggers and delays two miles north of Highway 44 to the Pennington-Lawrence County line.

Read More

Nov. 1, 2024

Tree clearing along U.S. Highway 385 begins Monday, Nov. 4.

Read More

Oct. 24, 2024

Pre-construction Activities to begin on U.S. Highway 385 between Pactola Dam and Sheridan Lake.

Read More

SDDOT is dedicated to working with communities and keeping the public informed during road construction projects.

Resources
